Subcontractor governance for field service: onboarding checklists, mobile evidence and QC spot-audit templates

Subcontractor governance for field service: onboarding checklists, mobile evidence and QC spot-audit templates

Onboarding sets the foundation for everything that follows.

Managing subcontractors in field service is genuinely uncomfortable. You need their coverage and flexibility, but every time a third-party tech shows up at a customer site wearing your company's name, your reputation is riding on someone you don't fully control.

Managing a mixed workforce where half your techs aren't actually yours

It gets harder as you scale. A commercial HVAC company I worked with grew from 12 internal techs to a network of 45 total — including 28 subcontractors — across three states. Customer complaints jumped noticeably in about six months. Not because the subs were bad. They just had no consistent way to verify work quality, track mobile evidence, or enforce standards across a mixed workforce.

Most field service companies stumble into this gradually. You call a trusted contractor when you're swamped. Add a few more during peak season. Before long, third-party techs are handling 30–50% of your service calls and you're still managing them through text messages, hoping for the best.

Why quality control breaks down at scale

The core problem isn't finding good subcontractors. It's maintaining visibility and standards once they're in the field. Your internal techs follow your processes, use your tools, and went through your training. Subcontractors show up with their own habits, their own paperwork, their own definition of "done."

What typically happens: you onboard a new sub with a handshake agreement and maybe a basic contract. They start taking jobs. Customer feedback trickles in weeks later — sometimes fine, often inconsistent. By the time you spot quality issues, they've already knocked out dozens of calls under your company name.

The gap widens because subcontractors naturally push back on operational overhead. They're independent for a reason. Ask them to fill out extensive paperwork or follow complex protocols and they'll just find another company to work with. But give them too much freedom and your service quality becomes a coin flip.

Across roughly 80 field service operations I've looked at — from appliance repair to commercial electrical — the ones that manage this well don't try to turn subcontractors into employees. They build lightweight governance systems that capture just enough information to maintain quality without creating unnecessary friction.

Building your subcontractor onboarding checklist

Onboarding sets the foundation for everything that follows. Skip steps here and you'll be chasing problems for months.

Essential onboarding components:

Documentation & Compliance (Day 1, ~30 minutes)

  1. Insurance certificates (general liability minimum $1M)
  2. Workers comp verification
  3. Business license and trade certifications
  4. W-9 or equivalent tax forms
  5. Background check authorization
  6. Non-compete/confidentiality agreements

Operational Standards (Day 1, ~60 minutes)

  1. Service level agreements (response times, completion windows)
  2. Photo evidence requirements for each job type
  3. Customer communication protocols
  4. Escalation procedures for complex issues
  5. Warranty and callback policies
  6. Invoice submission process

Technology Setup (Day 1, ~30 minutes)

  1. Mobile app installation and login credentials
  2. Photo upload training
  3. Job acceptance/rejection workflow
  4. Time tracking requirements
  5. Parts ordering permissions (if applicable)

Field Shadowing (Day 2–3, 4–8 hours)

  1. Ride along with a senior tech on 2–3 typical jobs
  2. Review photo evidence standards in real scenarios
  3. Practice customer interaction
  4. Demonstrate close-out procedures

This is different from your 90-day technician onboarding checklist for internal hires. Subcontractors need a compressed version — get them productive fast while making the boundaries crystal clear.

Verification gates before they go solo:

  1. Complete one supervised job with a passing score
  2. Submit proper photo evidence for the practice job
  3. Demonstrate basic app proficiency
  4. Sign off on all policies and procedures

Keep everything in a shared folder they can reference later. Most subs work with multiple companies and won't memorize your specific requirements — that's just reality.

Defining minimum mobile evidence requirements

Photo evidence is your remote quality control system. But asking for "photos of completed work" gets you blurry shots of random equipment that tell you nothing useful.

You need specific evidence requirements for each job type, communicated clearly and enforced consistently.

Universal requirements (every job):

  1. Arrival photo

    wide shot showing address or building number

  2. Before photo

    close-up of the specific issue or equipment

  3. During photo

    work in progress (proves they didn't just reset a breaker and leave)

  4. After photo

    same angle as the before shot showing resolution

  5. Completion photo

    wide shot of the work area cleaned up

  6. Customer signature or digital confirmation

Service-specific additions:

For HVAC work:

  1. Thermostat reading before and after
  2. Filter condition if replaced
  3. Refrigerant gauge readings
  4. Model/serial number plate

For plumbing:

  1. Water meter reading before work
  2. Pipe material and size
  3. Water flow demonstration video for drain clearing
  4. Shut-off valve locations

For electrical:

  1. Panel schedule/breaker identification
  2. Voltage readings
  3. Wire gauge verification
  4. GFCI test button demonstration

A pest control company I worked with cut callbacks by around 60% just by requiring techs to photograph specific evidence points — entry points sealed, bait station placements, treated areas. Before that, customers would claim work wasn't done and there was no way to verify either way.

The key is making evidence collection part of the natural workflow, not an afterthought. If techs have to remember a checklist after finishing a job, compliance drops fast. Build it into the flow: arrive, photo, diagnose, photo, fix, photo, verify, photo, close out.

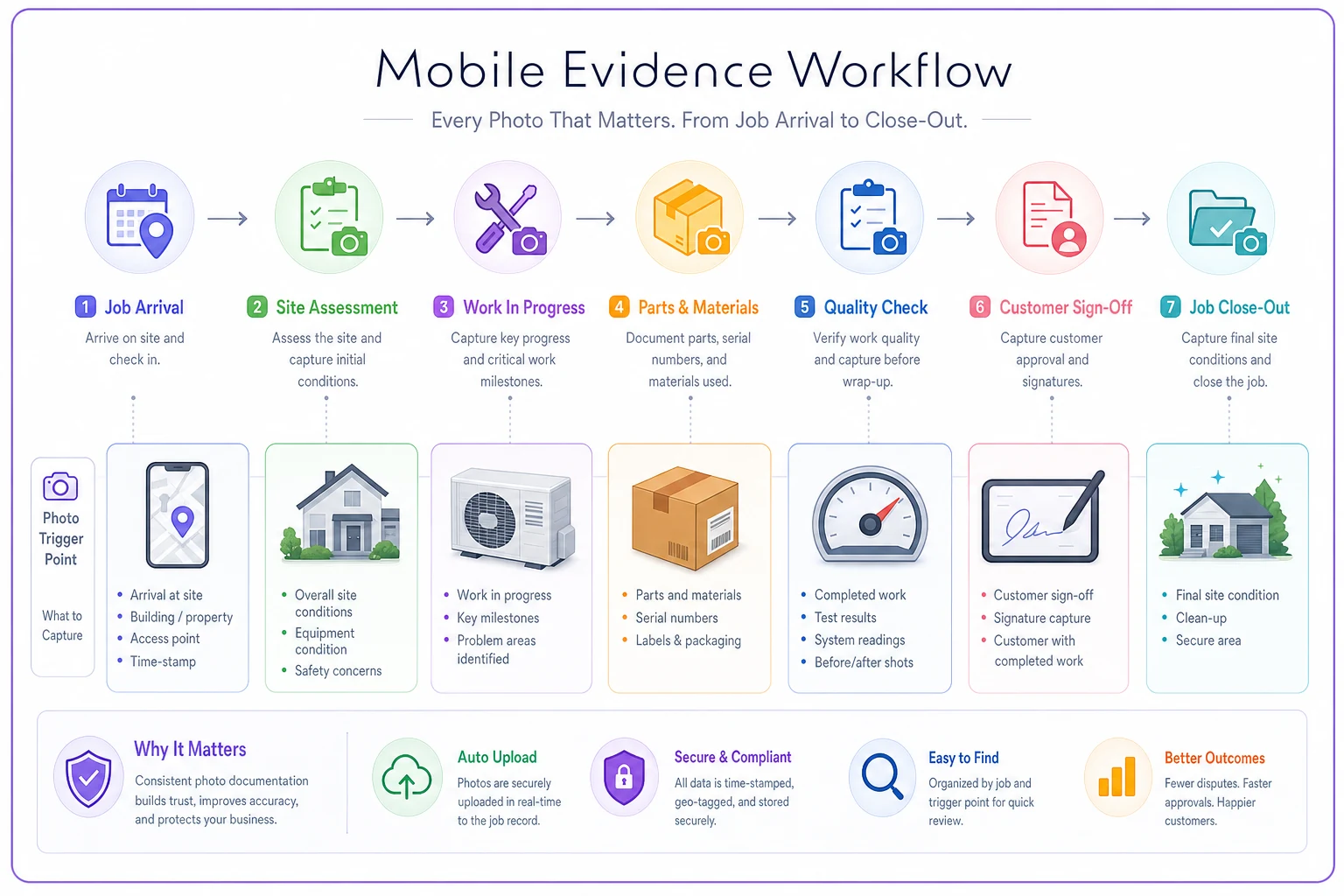

Here's a simple workflow showing the photo trigger points in sequence.

Process diagram

The graphic maps each photo point to the job stage so teams can enforce consistency.

Quality control spot-audit framework

Random audits keep everyone honest. Subcontractors who know they might get checked perform differently than those who think nobody's looking.

Auditing every job isn't realistic. You need a smart sampling approach that catches problems without burning out your QC team.

Audit triggers and frequency:

Trigger TypeAudit RatePriority Level
New subcontractor (first 30 days)100% of jobsCritical
New subcontractor (days 31–90)50% of jobsHigh
Established sub – standard performance10% random sampleNormal
Customer complaint100% for next 5 jobsHigh
High-value job (>$2,000)100% reviewHigh
Warranty claimPrevious 10 jobs reviewedCritical
Random monthly selection5% of all sub jobsNormal

Don't frame audits like an investigation. Call it "job review" or "quality verification." Subcontractors who feel targeted will find other work.

Audit checklist components:

Photo Evidence Review (~5 minutes)

  1. All required photos present?
  2. Photos show actual work, not something generic?
  3. Timestamps align with reported schedule?
  4. Location metadata matches job site?

Customer Contact (~5 minutes)

  1. Call or text customer within 48 hours
  2. Verify arrival/departure times
  3. Confirm work scope completed
  4. Check satisfaction (1–10)
  5. Note any concerns

Technical Review (~10 minutes)

  1. Work matches industry standards?
  2. Parts used align with the invoice?
  3. Warranty terms properly explained?
  4. Follow-up requirements documented?

Compliance Check (~5 minutes)

  1. Proper PPE visible in photos?
  2. Safety protocols followed?
  3. Customer property protected?
  4. Clean-up completed?

Track everything and look for patterns. A sub who passes individual audits might still show a concerning trend when you zoom out — and that trend won't show up if you're only looking job by job.

Setting measurable contract KPIs

Vague contracts create disputes. "Provide quality service" means nothing when a customer complains. You need specific, measurable performance indicators that both parties understand going in.

Your KPIs should reflect what actually matters for your business. A residential service company might prioritize first-time fix rates. A commercial contractor might care more about response times.

Core KPIs for subcontractor agreements:

Response and Completion

  1. Emergency response

    on-site within 2–4 hours

  2. Standard response

    on-site within 24–48 hours

  3. Job completion

    90%+ completed within quoted timeframe

  4. Schedule adherence

    85%+ arrival within a 30-minute window

Quality

  1. First-time fix rate

    75–85% minimum depending on service type

  2. Callback rate

    below 5% within 30 days

  3. Customer satisfaction

    8.0+ average

  4. Photo evidence compliance

    95%+ of jobs fully documented

Administrative

  1. Invoice accuracy

    95%+ error-free submissions

  2. Response to office

    within 2 hours during business hours

  3. Training compliance

    required updates completed within 7 days

Keep the numbers realistic. Setting impossible targets just encourages people to game the system. Companies that require 100% on-time arrival then wonder why subs mark every job as "emergency traffic delay."

Sample KPI tracking table:

SubcontractorJobs (Month)On-Time %Fix Rate %SatisfactionCallbacksStatus
ABC Plumbing4789%81%8.72Good
XYZ Electric3176%78%8.23Warning
123 HVAC5292%84%9.11Excellent

Review these monthly with each subcontractor. Don't sit on problems until a quarterly review — by then you've already absorbed the damage.

The remediation and penalty playbook

When standards slip, you need a consistent response. Arbitrary punishment breeds resentment. A clear escalation process helps good subcontractors improve while filtering out the ones who won't.

Most companies jump straight to termination threats. That burns relationships you didn't need to burn. A tiered approach works better.

Tier 1: Coaching (First Instance)

  1. Phone call within 24 hours to walk through the issue
  2. Review specific examples together
  3. Identify root cause — training gap, tools, unclear expectations?
  4. Document the conversation and improvement plan
  5. No financial penalty

Timeline: Resolve within 7 days.

Tier 2: Formal Warning (Second Instance or Pattern)

  1. Written warning via email
  2. Mandatory retraining on the specific issue
  3. Increased audit rate (25% of jobs) for 30 days
  4. Suspension from high-value jobs
  5. 5% invoice reduction for the period

Timeline: 30-day improvement window.

Tier 3: Probation (Serious or Continued Issues)

  1. Formal probation notice
  2. Reduced job allocation (roughly 50% of normal volume)
  3. 100% audit rate
  4. 10% invoice reduction
  5. Weekly check-ins
  6. No new job types approved

Timeline: 60-day probation.

Tier 4: Termination

  1. Contract termination per agreement terms
  2. Final invoice settlement
  3. Return of any company property
  4. Full documentation for legal protection

Some violations skip straight to termination: safety violations, customer abuse, fraud, or using your customer data to compete directly. Make these red lines explicit from day one, not after they've been crossed.

Common mistakes worth avoiding

Treating subs like employees without employee benefits

The fastest way to lose good subcontractors is to impose employee-level procedures without employee-level pay. They chose contract work for a reason. Respect that while maintaining your standards.

Using delayed payments as leverage

Holding invoices to enforce compliance backfires. Reliable subs won't tolerate payment games. Pay on time, every time, then handle performance issues separately.

Surprise requirements

Adding new requirements without notice or rate adjustments breeds resentment. If you need additional documentation or procedures, have the conversation first.

One-size-fits-all standards

A commercial HVAC sub doesn't need the same oversight as a residential handyman. Customize your governance based on service complexity and actual risk.

Ignoring good performers

Don't only manage problems. When subs consistently hit their KPIs, acknowledge it — preferred status, better rates, first pick on profitable jobs. Replacing a reliable subcontractor costs far more than keeping them happy.

Making governance operational

Manual tracking starts breaking down somewhere around 15–20 active subcontractors. Spreadsheets get messy, photos get buried in email chains, and maintaining any kind of audit trail becomes a real headache.

AI-powered operational software changes how subcontractor management actually works at scale. Instead of chasing contractors for photos, the platform prompts them at each stage automatically. Instead of manually calculating KPIs, dashboards stay current in real time. The coordination benefits alone are significant — subcontractors see schedules, accept jobs, and submit evidence in one place, while your team tracks performance, manages audits, and processes payments through the same system.

The automation handles the repetitive parts: tracking evidence submission, flagging missing documentation, calculating performance scores, triggering audit workflows. That frees you up for relationship management and actual decisions rather than administrative cleanup. Some platforms can even review photo evidence automatically, checking that images match job requirements and flagging potential issues before they turn into callbacks.

For context on how this connects to internal team coordination, the shift handover process follows similar principles around documentation and visibility — see dispatcher shift handover.

Planning your rollout

Don't implement everything at once. Subcontractors will push back if you suddenly impose complex new requirements. Phase it over about 90 days.

Days 1–30: Foundation

  1. Implement basic onboarding checklist
  2. Establish minimum photo evidence requirements
  3. Start tracking arrival and completion times
  4. Set up simple satisfaction surveys

Days 31–60: Measurement

  1. Launch KPI tracking
  2. Begin random spot audits (5% of jobs)
  3. Share first performance reports with subs
  4. Adjust requirements based on feedback

Days 61–90: Enforcement

  1. Activate remediation procedures
  2. Increase audit frequency for poor performers
  3. Recognize top performers
  4. Refine based on what the data is actually showing you

Communicate each phase in advance. Subcontractors appreciate knowing what's coming and why — and they're less likely to push back when they don't feel blindsided.

Wrapping up

Strong subcontractor governance isn't about turning contractors into employees or burying them in paperwork. It's about building lightweight systems that protect quality while respecting their independence.

The companies that do this well understand that balance. Clear onboarding, specific evidence requirements, smart audits, meaningful KPIs, and consistent responses to performance issues — that's the whole framework. It doesn't have to be complicated.

Technology makes governance systematic rather than adversarial. When subcontractors can easily submit evidence from their phone and see their performance scores without having to ask, compliance stops feeling like a burden. And when your team has a centralized view of what every sub is doing, you stop managing by instinct and start managing by actual data.

Start with the basics: document your requirements, standardize onboarding, and begin collecting photo evidence. Build from there based on what the data tells you. Within 90 days, you'll have real visibility over a mixed workforce that probably felt impossible to manage when you were running everything through text messages.

The ROI is straightforward — fewer callbacks, better satisfaction scores, reduced liability exposure, and subcontractor relationships that actually hold up over time. Your subcontractors want to do good work. Give them clear expectations, consistent feedback, and fair treatment, and most of them will help you grow.

Strong subcontractor governance isn't about turning contractors into employees or burying them in paperwork. It's about building lightweight systems that protect quality while respecting their independence.

The companies that do this well understand that balance. Clear onboarding, specific evidence requirements, smart audits, meaningful KPIs, and consistent responses to performance issues — that's the whole framework. It doesn't have to be complicated.

Technology makes governance systematic rather than adversarial. When subcontractors can easily submit evidence from their phone and see their performance scores without having to ask, compliance stops feeling like a burden. And when your team has a centralized view of what every sub is doing, you stop managing by instinct and start managing by actual data.

Start with the basics: document your requirements, standardize onboarding, and begin collecting photo evidence. Build from there based on what the data tells you. Within 90 days, you'll have real visibility over a mixed workforce that probably felt impossible to manage when you were running everything through text messages.

The ROI is straightforward — fewer callbacks, better satisfaction scores, reduced liability exposure, and subcontractor relationships that actually hold up over time. Your subcontractors want to do good work. Give them clear expectations, consistent feedback, and fair treatment, and most of them will help you grow.
